Utilities Upgrade Projects
Sanitary Pump Station #9 (Wolfe Road)
Project Details

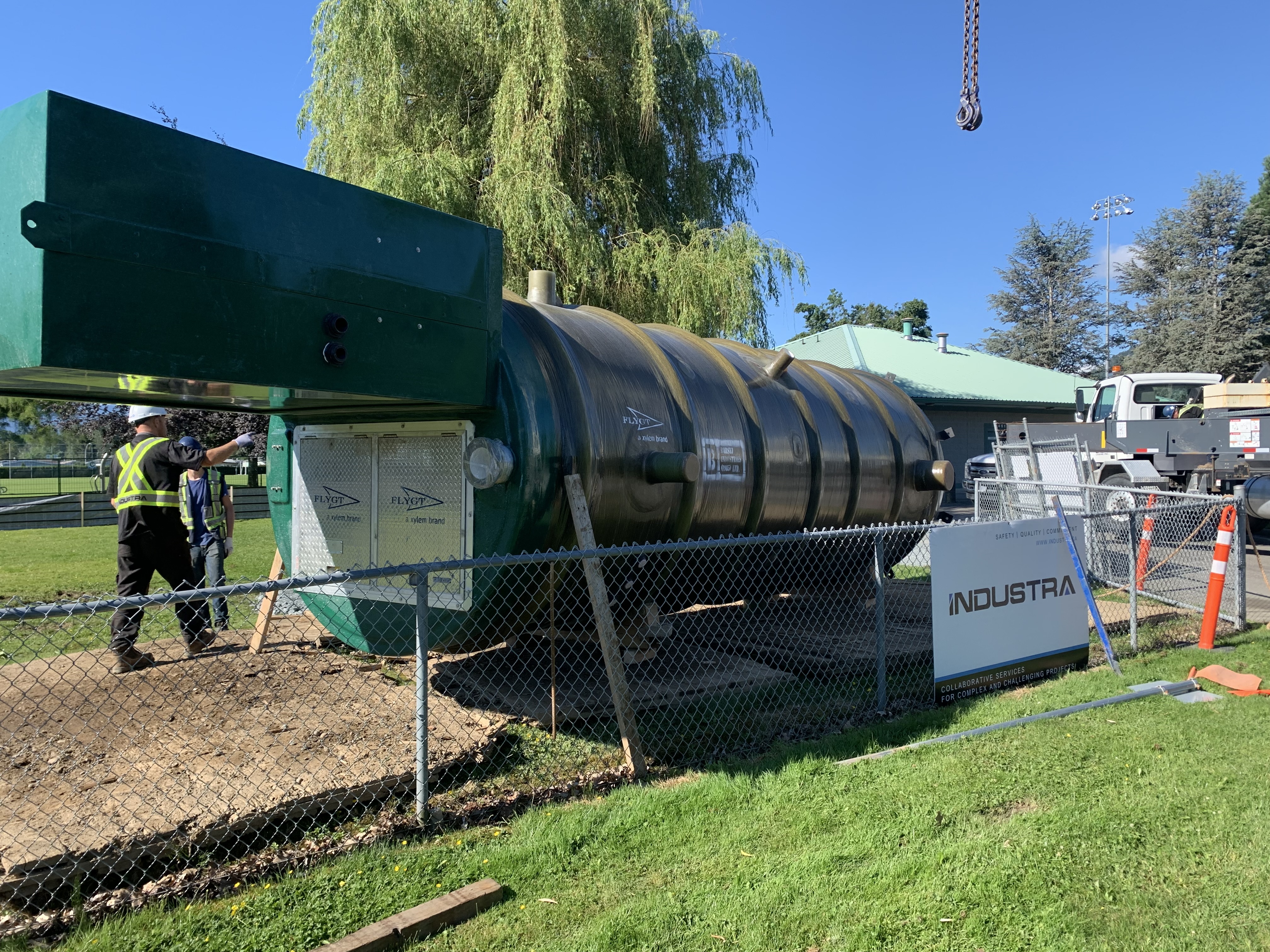

The existing sanitary pump station (SPS) has reached the end of its design life and the City is currently undertaking works to install a new duplex SPS as a replacement.

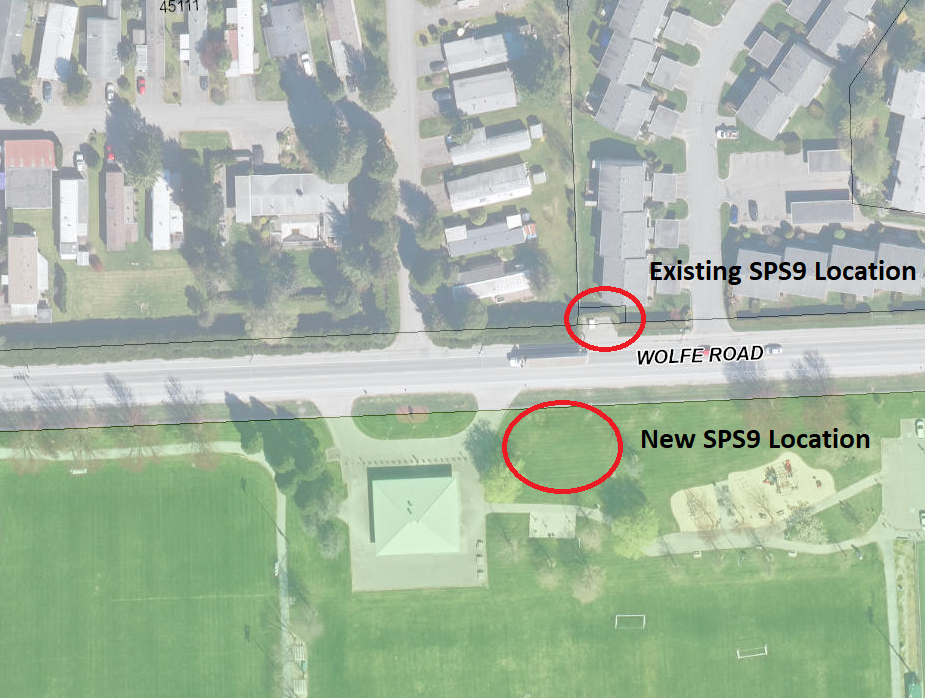

The installation of the new SPS will occur across the street from where the existing SPS is being decommissioned. The new location will allow for the necessary room to conduct regular maintenance activities.
The works include:
- decommissioning existing SPS and wet well
- involves dewatering equipment (in road) to lower groundwater table due to the well depth being deep
- required bypass pumping during the change over from existing station to new station
- the project is anticipated to be completed in October 2022
Prest Road Water Main Upgrade
(between Highway 1 and Prairie Central)
Project Details

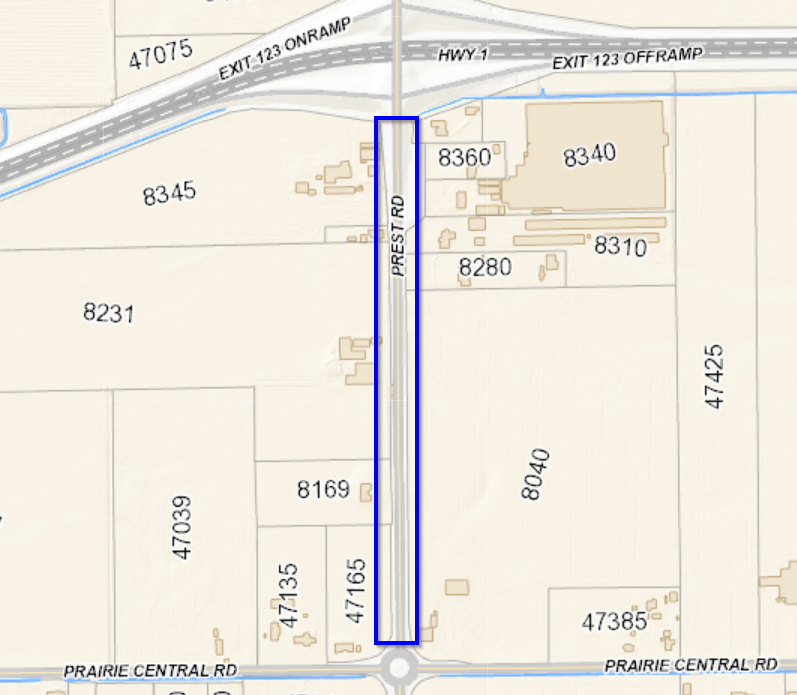

Approximately 680 meters of iron water main and 90 meters of water main installation has been installed along Prest Road from Prairie Central Road to south of Hwy 1. The also works included connection of all existing water service connections and pavement restoration.
Timeline
- final trench restoration work is anticipated to be complete in August.
Chilliwack River Road Water Main Upgrade
Project Details
Approximately 1605 meters of iron water main is being installed along Chilliwack River Road from McGuire Road to Bailey Road. The works will include connecting to existing water service connections and pavement restoration.
Timeline
- final trench restoration work is anticipated to be complete in August.
Yale & Hocking Sewer Upgrade
Project Details
Approximately 275 meters of PVC sanitary sewer pipe is being installed along Hocking Avenue and Yale Road. The works will include connecting to existing sanitary sewer connections and pavement restoration.
Timeline
- sanitary sewer pipe work completed Dec 2021
- final trench paving work completed in April 2022
- road markings in June 2022 (weather dependant)
Third Avenue Sewer Upgrade
Project Details
Approximately 250 meters of PVC sanitary sewer pipe is being installed along 3rd Avenue (south laneway) from Nowell Street to Williams Street. The works will include connecting to existing sanitary sewer connections and trench restoration.
Timeline
- sewer main installation work to be completed in April 2022
- final paving and restoration work in June 2022
